Already own a plot? This is the complete roadmap — documents, budget, approvals, hiring, construction sequence, and move-in.

The 10 stages: Verify land documents → soil test → set budget → hire architect → structural drawings → building plan approval → home loan → hire contractor → construction → Occupancy Certificate. Total time: 8–18 months.
Stage 1 — Confirm Your Land Is Construction-Ready
Skipping this is the most common cause of approval delays and demolition notices.
| Document | What It Confirms |
|---|---|
| Registered Sale Deed | Proof of ownership |
| Encumbrance Certificate (30-year) | No loans or legal claims on the land |
| Khata / Mutation Records | Ownership updated in municipal records |
| Property Tax Receipts | No pending dues |
| Approved Layout Plan | Plot is in a legal colony or scheme |
| Land Use Certificate | Residential construction is permitted |
| Survey Report | Plot boundaries match the title deed |
If your land is classified as agricultural, get it converted to residential (NA conversion) before applying for approval. This takes 2–6 months and varies by state.
Stage 2 — Get a Soil Test Done
A soil test determines your Safe Bearing Capacity — how much load the ground can carry. Your structural engineer uses this to decide your foundation type. Wrong foundation on weak soil = structural cracks within 3–5 years.
| Soil SBC | Foundation Type |
|---|---|
| Above 15 T/sqm | Isolated footing |
| 10–15 T/sqm | Combined or raft footing |
| Below 10 T/sqm | Raft or pile foundation |
Cost: ₹15,000–30,000. Most homeowners skip this and pay 10x later in repairs.
Stage 3 — Set Your Budget Before You Design
Fix your budget before your architect draws anything. Projects that go design-first overshoot by 30–50%.
Construction Cost Per Sqft (2026)
| City Tier | Standard | Premium |
|---|---|---|
| Tier 1 — Bengaluru, Mumbai, Delhi, Chennai | ₹2,200–2,800 | ₹2,800–3,500 |
| Tier 2 — Pune, Hyderabad, Ahmedabad, Kochi | ₹1,800–2,400 | ₹2,400–3,000 |
| Tier 3 — Indore, Jaipur, Patna, Nagpur | ₹1,600–2,200 | ₹2,200–2,800 |
| Tier 4 — Smaller towns | ₹1,400–1,800 | ₹1,800–2,400 |
Construction only — excludes land, architect, approvals, and interiors.

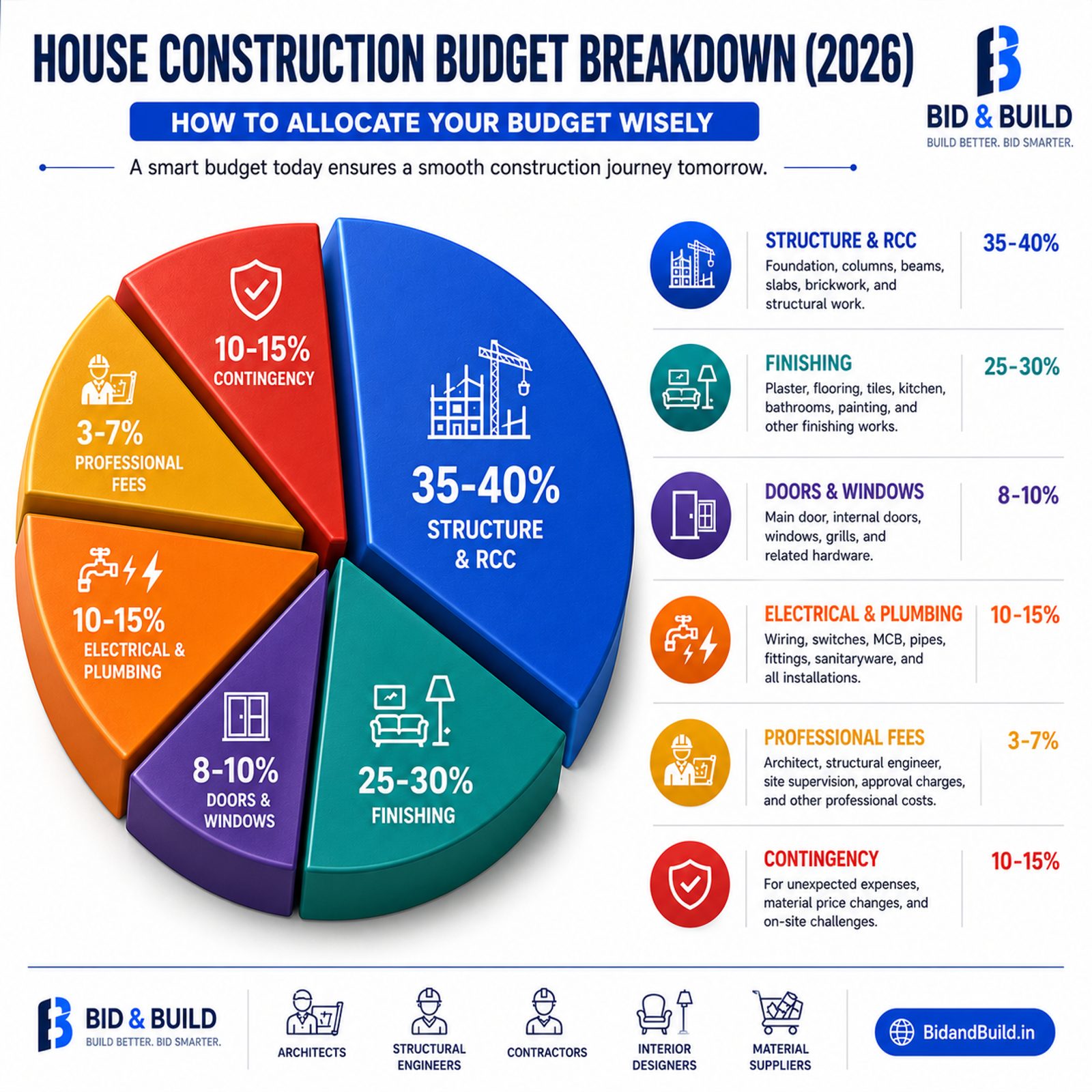

Full Cost Example — 2,400 sqft G+1, Tier 3 City
| Component | Cost |
|---|---|
| Architect fee | ₹1.5–3 lakh |
| Structural engineer + soil test | ₹50,000–1.5 lakh |
| Building plan approval | ₹75,000–1.5 lakh |
| Construction (₹1,800/sqft) | ₹43 lakh |
| Electrical + plumbing fixtures | ₹2.5–4 lakh |
| Interiors (kitchen, wardrobes, painting) | ₹6–12 lakh |
| Compound wall, gate, external work | ₹1.5–3 lakh |
| Connections, Khata, insurance | ₹1–2 lakh |
| Contingency (min. 10%) | ₹5–7 lakh |
| Total (excluding land) | ₹62–78 lakh |
Stage 4 — Hire an Architect
G+1 and above legally requires a COA-registered architect to sign the building plan. A good architect maximises usable area within bylaws, coordinates your structural engineer, and manages the approval process.
COA recommended fee:
| Construction Cost | Fee |
|---|---|
| Up to ₹50 lakh | 8–12% |
| ₹50 lakh – ₹2 crore | 6–10% |
| ₹2 crore – ₹10 crore | 5–8% |
Before signing: Verify COA registration at coa.gov.in, check portfolio for similar projects, confirm site supervision is included, and get the fee scope in writing.
Deliverables: Site plan, floor plans, elevations, sections, door/window schedule, approval drawing set.
Find verified architects in your city on BidandBuild — compare portfolios and request free consultations before committing to anyone.
Related: Best Architects in Indore 2026 · Top Architects in Patna 2026
Stage 5 — Get Structural Drawings
Architectural drawings define the look. Structural drawings define whether the building stands for 50 years. Both must be complete and coordinated before construction starts.
Your structural engineer produces: foundation layout, column layout, beam and slab layout, and a Structural Stability Certificate.
Minimum standards — insist on these:
| Material | Grade | IS Code |
|---|---|---|
| Concrete (RCC) | M25 | IS 456:2000 |
| Steel reinforcement | Fe 500D | IS 1786:2008 |
| Cement | 43G or 53G OPC | IS 8112 / IS 12269 |
Contractors often substitute M20 for M25 or Fe 415 for Fe 500D to cut cost. The price difference is small. The structural risk is not.

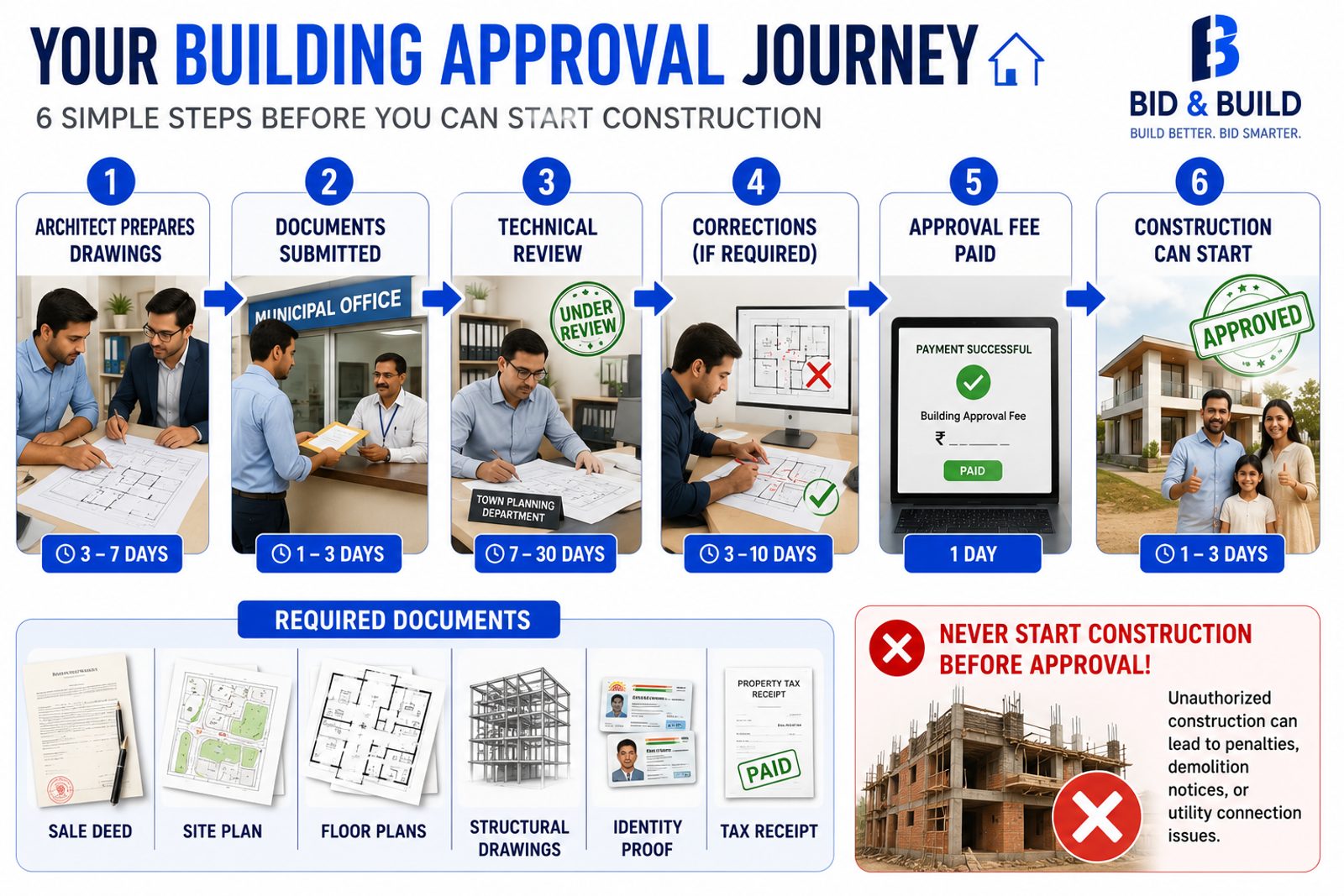

Stage 6 — Get Building Plan Approval
Building without approved plans is illegal — demolition orders, denied utility connections, no OC, no home loan, no legal sale.
| Step | Duration |
|---|---|
| Architect prepares drawings | 3–7 days |
| Submission and review | 7–30 days |
| Corrections (if any) | 3–10 days |
| Fee and approval | 1 day |
| Total | 3–8 weeks online · 2–4 months manual |
Authority by City
| City | Authority | Timeline |
|---|---|---|
| Bengaluru | BBMP / BDA | 30–45 days |
| Mumbai | MCGM / BMC | 45–90 days |
| Delhi | MCD / DDA | 30–60 days |
| Chennai | CMDA / GCC | 30–45 days |
| Hyderabad | GHMC / HMDA | 21 days (auto under 500 sqm) |
| Pune | PMC / PMRDA | 30–45 days |
| Indore | IMC | 30–60 days |
| Jaipur | JDA / JMC | 30–60 days |
| Patna | PMC / PMCP | 45–90 days |
| Gram Panchayat | GP office | 30–90 days |
Documents needed: Sale deed, site plan, floor plans, elevations, structural drawings, soil test report, encumbrance certificate, identity proof, property tax receipt.
Stage 7 — Arrange a Home Loan
Banks release construction loans in 4–5 tranches tied to site milestones — not as a lump sum.
| Feature | Details |
|---|---|
| LTV | 75–80% of construction cost |
| Rate (2025–26) | 8.5–9.5% floating |
| Pre-EMI | Interest only on each disbursed tranche |
| Tax benefit | Sec 24(b): ₹2L interest · Sec 80C: ₹1.5L principal |
Disbursement schedule:
| # | Milestone | % Released |
|---|---|---|
| 1 | Foundation complete | 15% |
| 2 | Plinth level | 15% |
| 3 | Ground floor slab | 20% |
| 4 | Roof slab | 25% |
| 5 | Finishing stage | 25% |
Get pre-approval before construction starts — not after. Running out of money after the structure is up is the most painful position to be in.
Stage 8 — Hire a Contractor
Contract types:
| Type | How It Works | Best For |
|---|---|---|
| Item Rate | Rate per work item — pay for actual quantities | Most residential projects |
| Lump Sum | Fixed total price | When design is 100% final |
| Labour Only | You buy materials, contractor provides labour | Max control, needs daily supervision |
Your contract must include:
- BOQ with item-wise rates and material brand/grade specs
- Milestone-based payment schedule — never time-based
- Completion date with penalty clause (₹500–2,000/day for delays)
- Defect liability period — minimum 12 months post-handover
- Written variation order process for any design changes
Milestone payments:
| # | Milestone | % |
|---|---|---|
| 1 | Mobilisation (against bank guarantee) | 10% |
| 2 | Foundation | 10% |
| 3 | Plinth | 10% |
| 4 | Ground floor slab | 10% |
| 5 | First floor slab | 10% |
| 6 | Brickwork | 10% |
| 7 | Plaster + plumbing + electrical rough-in | 15% |
| 8 | Flooring + tiling + painting | 15% |
| 9 | Final completion + snag clearance | 10% |
Never pay ahead of completed work.
Compare verified contractors on BidandBuild — review past projects and collect quotations in one place.

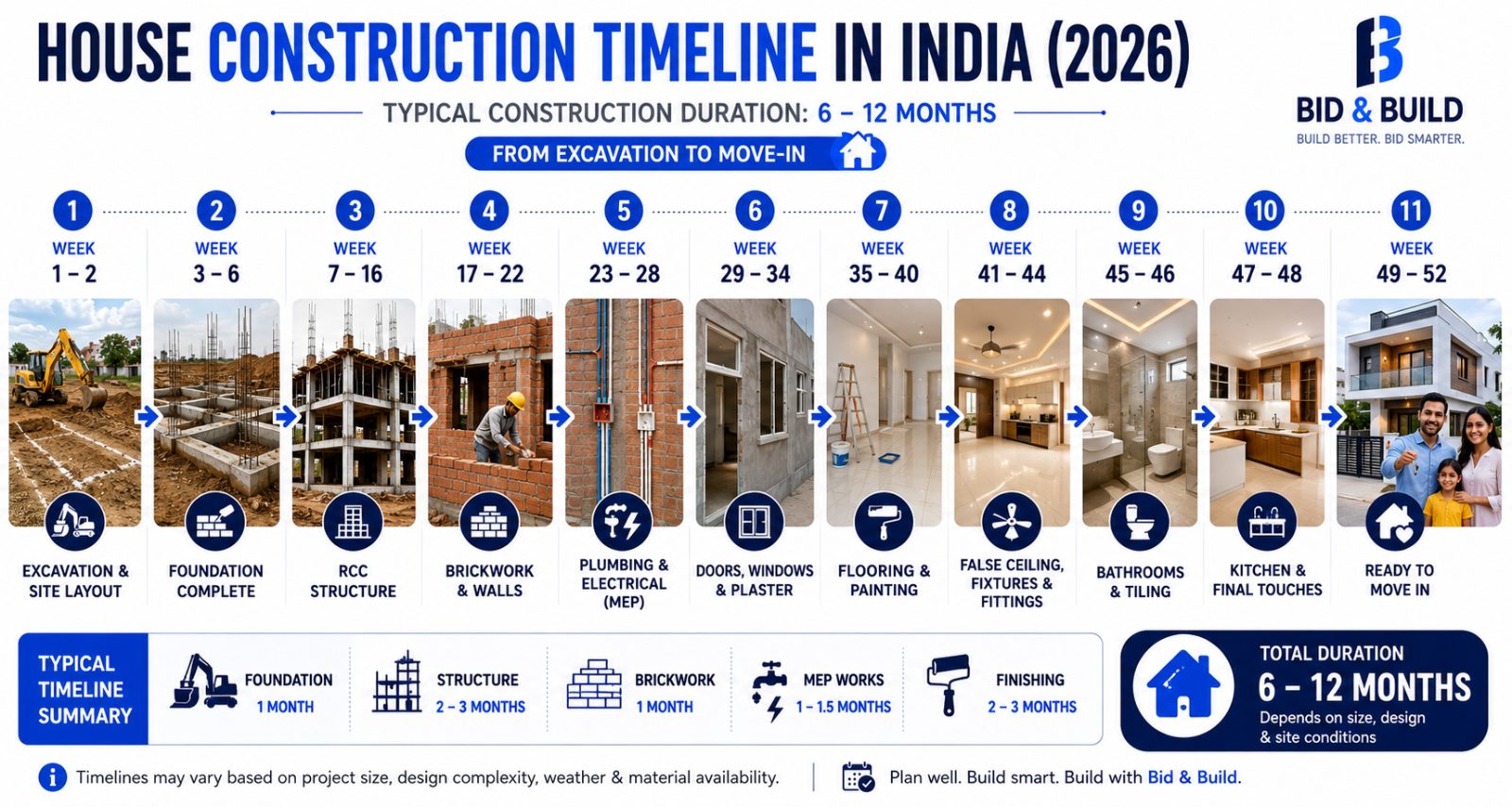

Stage 9 — Construction Sequence
| # | Stage | When |
|---|---|---|
| 1 | Excavation and layout | Week 1–2 |
| 2 | Foundation (PCC + RCC footings) | Week 3–5 |
| 3 | Plinth beam and backfill | Week 6–7 |
| 4 | Ground floor columns | Week 8–9 |
| 5 | Ground floor beams and slab | Week 10–13 |
| 6 | Ground floor brickwork | Week 14–17 |
| 7 | Repeat structure for upper floors | +4–6 weeks per floor |
| 8 | Concealed plumbing and electrical | Week 22–26 |
| 9 | Waterproofing (terrace + bathrooms) | Week 27–28 |
| 10 | Plastering | Week 29–33 |
| 11 | Flooring and tiling | Week 34–38 |
| 12 | Doors, windows, painting | Week 35–42 |
| 13 | False ceiling and fixtures | Week 43–45 |
| 14 | Kitchen and bathroom fittings | Week 46–47 |
| 15 | Snag list and handover | Week 48–52 |
G+1: 8–14 months. G+2 or larger: 12–18 months.
Monsoon: June–September disrupts RCC and exterior work by 4–6 weeks. Plan your structure for October–May where possible.
Stage 10 — Before You Move In
Do a full snag inspection with your architect before final payment.
Check every room for:
- Structural cracks wider than 1mm running through walls
- Dampness on external walls
- Leaks at any plumbing joint
- Water pooling on bathroom/balcony floors (wrong slope to drain)
- Switches not operating the correct points
- Tiles with hollow sound when tapped (poor bonding)
- Paint shade variation between walls
Occupancy Certificate (OC)
Without OC — you cannot legally inhabit, get permanent utility connections, take a home loan, or sell the property.
Submit through your architect: completion certificate, structural stability certificate, plumbing certificate, electrical inspection report, and rainwater harvesting certificate.
Post-OC Formalities
| Step | Time | Cost |
|---|---|---|
| Khata transfer | 15–30 days | ₹5,000–15,000 |
| Electricity connection | 7–15 days | ₹5,000–20,000 |
| Water connection | 15–30 days | ₹10,000–30,000 |
Moving into interiors next? BidandBuild has verified interior designers too — same platform, no starting over.
Common Mistakes to Avoid
Skip the soil test — wrong foundation type costs ₹5–20 lakh to fix later.
Start construction before approval — demolition risk, no OC, no home loan, no sale.
Verbal contractor agreement — every dispute and abandoned site starts here. Always a written contract with BOQ.
Pay large advances — pay milestone by milestone. Advances give you no leverage when work stalls.
Change design mid-construction — a single wall shift after RCC costs ₹50,000–2 lakh. Lock everything on paper first.
Skip waterproofing — terrace leaks are India's #1 post-construction complaint. It costs 1–2% of budget to do right; 10–15% to fix later.
Compare only price — cheapest quote usually means thinner scope or lower-grade materials. Compare on identical BOQs.
FAQs
How much does it cost to build a 1,000 sqft house in India in 2026? In a Tier 3 city: ₹16–22 lakh construction + fees, approvals, fixtures, contingency = ₹21–30 lakh excluding land.
How much does it cost to build a 1,500 sqft house? Tier 2 standard: ₹27–36 lakh construction. Total with all costs and contingency: ₹35–50 lakh excluding land.
Is building plan approval mandatory? Yes. Without it: demolition risk, no OC, no home loan, no legal sale.
Do I need a soil test? Yes. It's the only way to know your foundation type. Skipping it is a structural gamble.
What's the difference between an architect and a structural engineer? Architect designs layout and look. Structural engineer ensures it carries loads safely. You need both before any RCC starts.
What's the difference between a Completion Certificate and an OC? CC is from your architect — confirms building is complete as designed. OC is from the municipal authority — confirms it meets all bylaws. You need CC to apply for OC.
Can I build using daily labour instead of a contractor? Yes — you buy materials and hire labour directly. Saves 10–15% but needs someone with construction knowledge on site every day.
How long does building plan approval take? 3–8 weeks via online portals. 2–4 months for manual or Gram Panchayat areas. Hyderabad auto-approves under 500 sqm in 21 days.
Can I get a home loan before construction starts? Yes. Get pre-approval first — it confirms your budget ceiling and prevents mid-construction funding gaps.
Find verified architects, contractors, and structural engineers on BidandBuild → Compare portfolios, read reviews, and get free quotations — all in one place.
Mahendra Raj Bharti is a practising architect (B.Arch, MNIT Jaipur) and founder of BidandBuild, India's verified marketplace for architects, contractors, structural engineers, and interior designers.
